The most common venue electrical failures are RCD nuisance trips, overloaded circuits, generator earthing faults, damaged cables and connectors, unlabelled distribution, and supply instability from non-linear loads. When any of these occur, the immediate steps are: isolate the affected supply, secure the area, evacuate if there is any risk to people, contact your named Senior Person Responsible (SPR) or competent electrician, and log the incident with time and circumstances.
These failures are not random. Most trace back to gaps in planning, inadequate testing, or contractors unfamiliar with temporary electrical systems for entertainment. The governing framework in the UK is BS 7909:2023+A1:2024, which sits alongside BS 7671 (the IET Wiring Regulations) and HSE Guidance Note GS50. Between them, these documents cover every failure type below and what to do about it.
Immediate action checklist:
- Isolate the supply at the nearest labelled isolator or distribution board
- Keep people away from the affected area
- Evacuate if there is any sign of fire, arcing, or electric shock
- Call the SPR or competent person immediately
- Do not restore power until the fault is identified and rectified
- Log the incident: time, location, symptoms, and actions taken
Table of Contents
- Common venue electrical failures: symptoms, causes, and fixes
- Why temporary event systems are especially vulnerable
- Practical mitigations: how to stop these failures before they happen
- Inspection, testing, and records: what to require from contractors
- Generator-specific failures and how to avoid them
- What to ask your temporary electrical contractor
- How often should you inspect and test?
- When does a temporary system need re-testing?
- Timeline and budget: what to plan for
- Troubleshooting specific failures on the day
- Making temporary systems work with venue infrastructure
- Key takeaways
- The thing most planners get wrong
- Jakspartypower: power, compliance, and standby cover for UK events
- Useful UK sources and standards
- FAQ
Common venue electrical failures: symptoms, causes, and fixes
1. RCD nuisance tripping
Symptom: Circuits go dead without an obvious overload. Cause: Earth leakage from LED drivers, dimmers, or long cable runs accumulating leakage current across multiple circuits fed by a single RCD. Fix: Fit 30 mA RCDs at sub-circuit level rather than relying on one device for the whole system. GS50 is explicit on this: a single RCD protecting everything means one trip kills all power simultaneously.
2. Overloaded circuits and blown fuses
Symptom: Fuses blow or MCBs trip repeatedly. Cause: Load schedule not prepared in advance; equipment added on the day without checking capacity. Fix: Prepare a full load schedule before the event, balance loads across phases, and never exceed the rated capacity of any distribution board or cable.
3. Generator earthing and bonding faults
Symptom: Equipment casings become live; RCDs fail to operate; electric shock risk. Cause: Generator neutral/star point not earthed, or structural steelwork and scaffolding not bonded. This is one of the highest-risk failures on site. Fix: Earth the generator neutral and bond all metallic structures before energising. See the generator section below for the full checklist.

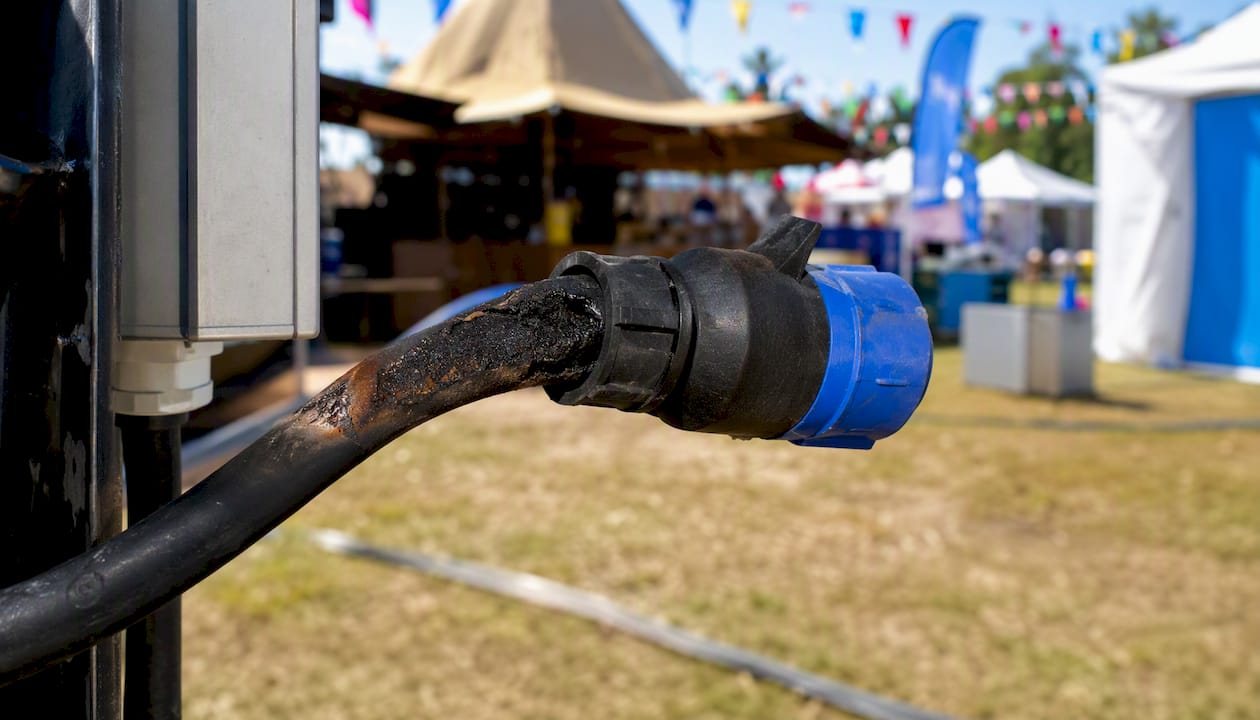

4. Damaged cables and incorrect terminations
Symptom: Intermittent power loss, visible scorching, hot connectors. Cause: Cables run across vehicle routes without protection, connectors forced into wrong sockets, or insulation damaged during previous hire. Fix: Route cables via ramps, bridges, or catenary; inspect every connector before use; replace any cable with damaged insulation immediately.
5. Unlabelled or poorly organised distribution
Symptom: Wrong circuits isolated during a fault; slow fault-finding; accidental power loss to safety-critical equipment. Cause: Distribution boards installed without labelling or with labels that do not match the actual connected loads. Fix: Label every way on every board before power-up. Event power distribution should be documented in a single-line diagram available to the SPR at all times.
6. Supply instability from non-linear loads
Symptom: Flickering, unexplained RCD trips, overheating neutrals. Cause: LED drivers, switch-mode power supplies, and dimmers generate harmonics that standard designs do not account for. Annex K of BS 7909 addresses this directly. Fix: Specify equipment with low harmonic distortion; oversize neutral conductors; consult Annex K when planning any event with significant LED or dimmer loads.
7. Dimmer-induced earth leakage
Symptom: RCDs trip when dimmers are in use, even at low loads. Cause: Thyristor and IGBT dimmers produce leakage current that accumulates and trips sensitive RCDs. Fix: Use RCDs rated for use with non-linear loads on dimmer circuits, or fit separate circuits for dimmer racks with appropriate protection.
Why temporary event systems are especially vulnerable
Temporary systems are reconfigured for every event, often by different crews, in different weather, with variable loads. That combination creates failure modes that permanent installations rarely face.
BS 7909:2023+A1:2024 distinguishes between small/simple systems (under 6 kVA, where instructed persons may operate them) and large/complex systems (requiring electrically skilled personnel, formal design, and full testing). Most multi-stage events fall into the large/complex category, which triggers the duty to appoint a named SPR.
Key vulnerability factors:
- Cables are laid and re-laid across ground subject to foot traffic, vehicles, and rain
- Loads change between rehearsal and show without the distribution being re-checked
- Generators introduced mid-event without earthing verification
- Long extension leads can negate the protection of upstream RCDs
- Dimmers and LED rigs interact with RCDs in ways a standard domestic or commercial installation never would
BBC safety guidance on temporary electrical systems warns that the biggest single mistake is testing equipment in isolation. Interaction faults only appear when the full system runs under real load.
Practical mitigations: how to stop these failures before they happen
The most effective mitigations are system-level design to BS 7909, a named SPR on site, full integrated testing before the event opens, and labelled distribution with spare equipment available.
Planning stage:
- Prepare a load schedule and single-line diagram
- Confirm venue supply capacity and earthing arrangements in writing
- Plan cable routes to avoid vehicle crossings; specify ramps or catenary where needed
- Check weather exposure for all distribution and generator positions
Procurement:
- Specify 30 mA RCDs at sub-circuit level, not a single device for the whole system
- Use correctly rated, undamaged cables with appropriate IP ratings for outdoor use
- Hire from suppliers who can provide a Temporary Electrical Installation Certificate (TEIC)
On the day:
- Run a phased power-up with all loads connected before the event opens
- Test every RCD using the test button and log the results
- Walk all cable routes after installation and after any changes
Pro Tip: Never use a single RCD to protect an entire lighting rig. One nuisance trip from a dimmer kills all stage lighting simultaneously. Sub-circuit RCDs limit the blast radius to one circuit and make fault-finding far faster.
| Mitigation | When | Who |
|---|---|---|
| Load schedule and single-line diagram | Planning stage | SPR / contractor |
| Venue supply capacity confirmed | Pre-event | Venue and contractor |
| Cable routes and protection specified | Pre-event | SPR |
| Sub-circuit 30 mA RCDs fitted | Installation | Contractor |
| Full integrated system test | Before event opens | SPR / contractor |
| RCD test button checks logged | Day of event | SPR |
| Spare fuses, RCDs, connectors on site | Day of event | SPR |
Inspection, testing, and records: what to require from contractors
Insist on a Temporary Electrical Installation Certificate (TEIC) as the primary evidence of BS 7909 compliance. No TEIC means no evidence the system has been properly designed and tested.
A BS 7909 inspection covers visual checks, earth electrode resistance measurement, RCD testing, load testing, and phase balancing. Each of these must be documented.
| Record | Provided by | Frequency |
|---|---|---|
| TEIC | Contractor / SPR | Each installation |
| Method statement | Contractor | Each event |
| Risk assessment | SPR / event organiser | Each event |
| RCD test log | SPR | Each event, plus monthly |
| Earth electrode resistance | Contractor | Each installation |
| PAT records | Contractor | Per equipment item |
| EICR (venue fixed wiring) | Venue | Per BS 7671 schedule |
Practical inspection guidance recommends user visual checks before every use. A methodical walk-round before power-up can detect most electrical faults or damage and is one of the cheapest risk-reduction steps available.
Generator-specific failures and how to avoid them
Generator earthing and bonding failures are among the most dangerous on any event site. An unbonded generator can make equipment casings live without tripping any protective device, because the fault current has no return path.
On arrival:
- Confirm the generator has an earthing certificate and TEIC
- Check the earth spike is driven into firm ground, not under wheels or on hard standing without an alternative
- Verify bonding straps connect the generator frame to any structural steelwork or scaffolding
- Confirm the neutral/star point is earthed at the generator, not at a remote distribution board
At start-up:
- Check fuel level and coolant before starting
- Verify phase rotation matches venue supply if paralleling
- Run at no load for two minutes before connecting distribution
- Check output voltage and frequency before energising loads
Red flags — refuse use if:
- No earthing certificate or TEIC available
- Earth spike missing or incorrectly positioned
- Bonding straps absent from metallic structures
- Visible damage to output connectors or cables
- Signs of overheating on previous connections
Generator hire should always include earthing documentation as a standard deliverable, not an optional extra.
What to ask your temporary electrical contractor
Start with three non-negotiables: BS 7909 experience (not just general electrical competence), membership of a competent person scheme (NICEIC, ECA, or NAPIT), and a named SPR in writing before work begins.
- Can you provide a TEIC on completion?
- Who is the named SPR, and what is their BS 7909 experience?
- What competent person scheme are you registered with?
- Can you provide a method statement and risk assessment before installation?
- How are RCDs arranged — sub-circuit or single device?
- What is your earthing and bonding approach for the generator?
- Can you provide sample test results from a comparable previous event?
- Do you offer 24/7 standby cover during the event?
Red flags:
- Contractor unfamiliar with BS 7909 by name
- Refusal to test the full integrated system under load
- No documented earthing/bonding approach
- TEIC described as unnecessary for “small” events without checking the system size
Competent person scheme membership (NICEIC, ECA, NAPIT) is a baseline, not a guarantee of temporary-systems experience. Always verify BS 7909 knowledge specifically.
How often should you inspect and test?
For temporary event systems, the testing cadence is event-driven rather than calendar-driven. A full inspection and integrated test is required before every event. Within an event, HSE GS50 recommends monthly RCD test-button operation as a minimum, with quarterly tests in accordance with BS 7671 until a suitable interval is established for the specific installation.
User visual checks should happen before every use: inspect cables for damage, check connectors are fully engaged, confirm distribution boards are dry and undamaged. These take minutes and catch the majority of developing faults before they become failures.
When does a temporary system need re-testing?
Re-testing is required whenever a substantial change is made to the distribution. Specific triggers:
- The system moves to a new location
- Equipment is added or removed from the distribution
- The power source changes (venue supply to generator, or vice versa)
- Any component is damaged and replaced
- The system is de-energised and re-energised after a significant break
Simple repeated setups at the same location with identical equipment may allow abridged checks after the initial full certification, but this requires the SPR to confirm in writing that the configuration is unchanged.
Timeline and budget: what to plan for
Allow at least four weeks before the event to confirm venue supply capacity, appoint a contractor, and agree the load schedule. Complex multi-stage events need longer. Testing and commissioning typically takes half a day for a medium-sized event; larger festivals need a full day or more.
Budget for the TEIC, method statement, risk assessment, and standby cover as fixed line items, not optional extras. Cutting these is where most post-incident investigations find the gap. Event power planning should treat electrical compliance costs the same way as venue hire: non-negotiable before the event opens.
Troubleshooting specific failures on the day
RCD trip, circuit dead:
- Identify which RCD has tripped from the distribution label
- Disconnect all loads on that circuit
- Reset the RCD. If it holds, reconnect loads one at a time to identify the faulty item
- If it trips immediately with no load connected, the fault is in the cable or distribution; call the SPR
Generator not producing power:
- Check fuel level and oil pressure warning lights
- Check output voltage at the generator terminals before the distribution
- If voltage is present but distribution is dead, check the main isolator and incoming connections
- If no output voltage, shut down and call the generator supplier
Overheating connector or cable:
- Isolate the circuit immediately
- Do not reconnect until the cable or connector is replaced
- Check the load against the cable rating; overheating almost always means the cable is undersized or damaged
Making temporary systems work with venue infrastructure
Integration failures happen when temporary systems are connected to venue infrastructure without checking compatibility first. The most common causes: mismatched earthing systems (TN-S venue supply connected to a TT generator without isolation), phase rotation mismatch when paralleling supplies, and overloading venue distribution that was never designed for event loads.
Before connecting any temporary system to a venue supply:
- Obtain the venue’s Electrical Installation Condition Report (EICR) and confirm the supply type (TN-S, TN-C-S, TT)
- Confirm available fault current and supply impedance with the venue’s responsible person
- Check phase rotation if connecting three-phase equipment
- Never parallel a generator with the venue supply without an automatic transfer switch or manual changeover that prevents back-feeding
Where the venue supply is inadequate, a dedicated generator with its own earthing system is the correct solution, not an attempt to supplement an undersized venue supply.
Key takeaways
Preventing electrical failures at events comes down to three things: appointing a competent SPR, testing the whole integrated system before the event opens, and fitting 30 mA RCDs at sub-circuit level throughout.
| Point | Details |
|---|---|
| Appoint a named SPR | BS 7909 requires a Senior Person Responsible for all but the smallest temporary systems. |
| Test the full integrated system | Isolated component tests miss interaction faults; always test under real load before the event opens. |
| Sub-circuit RCDs at 30 mA | A single RCD for the whole system means one trip kills all power; sub-circuit devices limit the impact. |
| Earth and bond every generator | Unbonded generators create dangerous touch voltages without tripping any protective device. |
| Jakspartypower for standby support | Jakspartypower provides generator hire, distribution, and on-site standby cover for UK events. |

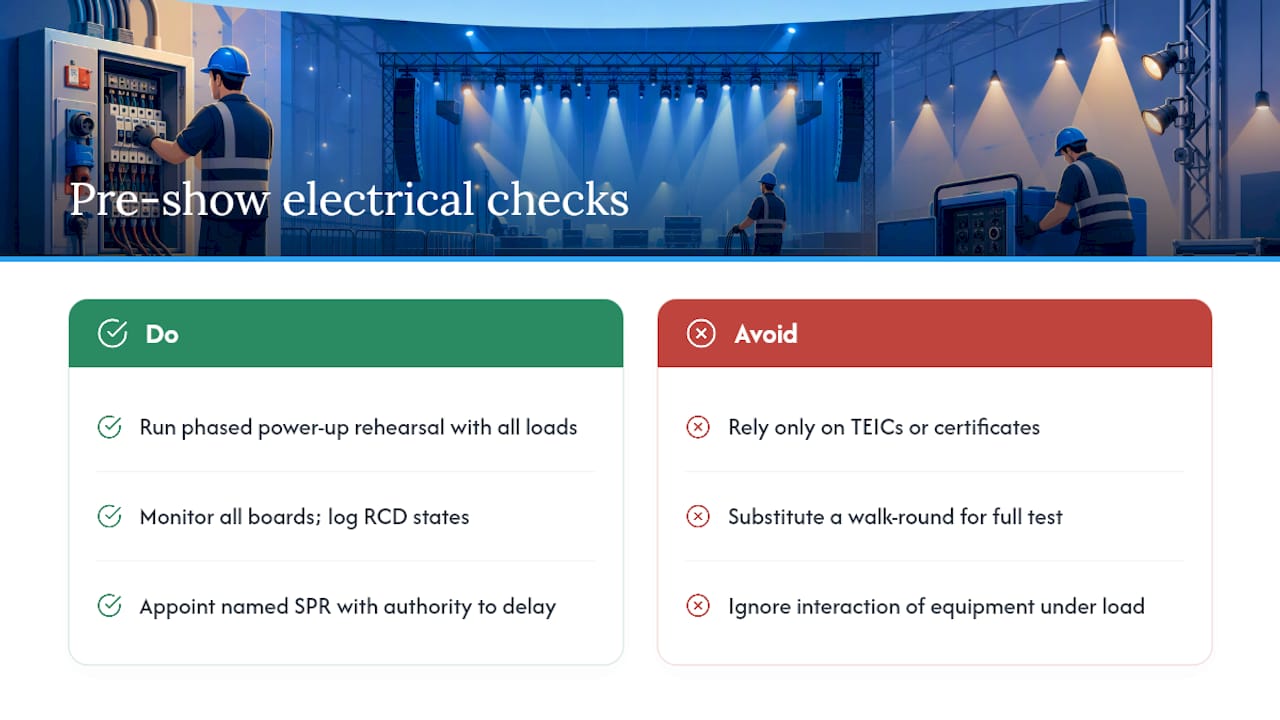

The thing most planners get wrong
The standard advice is to hire a competent electrician and get a TEIC. That is correct, but it misses the real failure point: most electrical incidents at events happen not because the equipment is faulty, but because the system was never tested as a complete, loaded whole before the audience arrived.
A contractor can produce a TEIC for every individual item and still miss the interaction between a dimmer rack, a long cable run, and a 30 mA RCD on the same circuit. The fault only appears when everything runs together. That is why a phased power-up rehearsal with all loads connected is the single most valuable thing you can do the day before an event. Not a walk-round. Not a visual check. A full energised rehearsal, with someone watching every distribution board and logging every RCD state.
The SPR appointment matters for the same reason. A named, competent person on site who knows the system, has the single-line diagram in hand, and has the authority to delay the event if something is wrong is worth more than any certificate. Certificates describe what was true at the moment of testing. The SPR is responsible for what is true right now.
Jakspartypower: power, compliance, and standby cover for UK events
Reliable event power starts well before the day itself, and that is exactly where Jakspartypower’s 40-plus years of electrical contracting experience makes a practical difference. Rather than assembling power from multiple suppliers and hoping it integrates, you get a single point of contact for generator hire, distribution boards, cabling, and on-site standby support, with the electrical knowledge to ensure the whole system is earthed, tested, and compliant with BS 7909.
For events in Sussex and across the UK, Jakspartypower can supply equipment, advise on load schedules, and provide standby cover so there is a competent person on site if something goes wrong. Get in touch via jakspartypower.com to request a quote or discuss standby arrangements for your next event.
Useful UK sources and standards
- Electrical safety at places of entertainment Guidance Note GS50 (Fourth edition) GS50
- BS 7909:2023+A1:2024 | BSI Knowledge
- Temporary electrical systems and BS 7909 — BBC safety resources
- BS 7909 guidance document (local authority guidance)
- Electrical inspections of temporary event electrics to BS 7909
- Temporary electrical systems (IET) — Annex K on power quality
Keep copies of the TEIC, EICR, method statement, risk assessment, RCD test logs, and earth electrode resistance results in a single event file. If an incident occurs, these are the first documents an HSE inspector will ask for.
This article provides general guidance on event electrical safety in the UK. It is not a substitute for professional electrical advice. Always engage a competent person with BS 7909 experience and confirm current requirements with HSE or a qualified electrician before your event.
FAQ
What is the most common cause of power loss at events?
RCD nuisance tripping is the most frequent cause, usually from accumulated earth leakage across multiple circuits fed by a single device. Fitting 30 mA RCDs at sub-circuit level prevents one trip from killing all power.
What is a Senior Person Responsible (SPR) under BS 7909?
The SPR is the named competent person responsible for the design, installation, testing, and safe operation of a temporary electrical system. BS 7909 requires one for all but the smallest systems.
When does a temporary electrical system need re-testing?
Re-testing is required after any change of location, addition of equipment, change of power source, or damage to any component. A full integrated test is required before every new event.
What documents should I request from my electrical contractor?
Request a TEIC, method statement, risk assessment, RCD test log, earth electrode resistance results, and proof of competent person scheme membership (NICEIC, ECA, or NAPIT) with specific BS 7909 experience.
Can Jakspartypower provide standby cover during an event?
Yes. Jakspartypower offers on-site standby support alongside generator hire and distribution for events in Sussex and across the UK. Contact them via jakspartypower.com to discuss requirements.
