Treat every temporary cable run as part of the site safety plan: design the routes before anything else is placed, protect cables against foot and vehicle traffic, and appoint a named competent person to oversee installation and handover. Do those three things and you have addressed the majority of electrical incidents at live events.
Right now, before the build starts:
- Mark every cable corridor on your site plan, noting where vehicle routes, pedestrian flows and emergency exits cross.
- Uncoil all cable drums fully before connecting them under load.
- Confirm a Senior Person Responsible (SPR) is named in writing and on site for the duration of the build.
BS 7909:2023 is the code of practice that governs temporary electrical systems at entertainment events, and HSE guidance GS50 sets out the practical measures every organiser must follow. Jakspartypower has supported events across Sussex for over 40 years, applying both standards on sites ranging from private weddings to large outdoor shows.
Key takeaways
Safe power cable management at events requires a named competent person, routes planned before the build starts, and every cable protected and tested before the system is energised.
| Point | Details |
|---|---|
| Appoint an SPR first | Name a Senior Person Responsible in writing before any cable is laid; they sign the handover document. |
| Plan routes on the site plan | Mark cable corridors, vehicle crossings and emergency routes before structures are placed. |
| Uncoil drums completely | Partially wound reels overheat under load; always uncoil fully before connecting. |
| Test RCDs before energising | Every 30 mA RCD must be tested and trip times recorded before the system goes live. |
| Jakspartypower provides full support | Generator hire, distribution boards, cable hire, on-site electricians and signed handover in Sussex. |
Table of Contents
- Why does power cable management matter at events?
- What cable types do you actually encounter at events?
- How do you integrate cable routing into the site plan?
- What containment options actually protect cables on site?
- Generators, distribution boards, RCDs and UK compliance
- What pre-event checks should you complete before powering up?
- How do you manage vehicle crossings, wet areas and high-traffic zones?
- Who is responsible, and what does the handover document contain?
- What are the most common failures and red flags to watch for?
- Practical checklist and a sample handover template
- What long-term event power work actually teaches you
- Jakspartypower: event power and cable management support in Sussex
- Sources
- FAQ
Why does power cable management matter at events?
“Temporary” is a description of duration, not a reduction in legal duty. The Electricity at Work Regulations 1989 require that all electrical systems, including those erected for a single day, are constructed, maintained and used so as to prevent danger. That obligation sits with the duty holder, which in most event contexts means the organiser and the contractor jointly.
BS 7909:2023 makes the planning and competence requirements explicit: a named person must take responsibility for the design, installation, testing and handover of the temporary system. BS 7671 (the IET Wiring Regulations) applies to the fixed elements of any temporary supply, including distribution boards and earthing arrangements. Neither standard allows for improvisation.
The consequences of poor cable management go beyond regulatory risk. A tripped performer, a shorted distribution board, or a generator fault during a headline act can end an event, void insurance and, in the worst cases, cause serious injury. The BBC safety resources note that even small temporary systems must comply with BS 7909 and that a nominated SPR must plan, co-ordinate and hand over the installation. Appointing that person is not a formality; it is the single most important structural decision an organiser makes before a cable is laid.
For a broader overview of what temporary supply actually involves, the Jakspartypower guide on what is temporary event power covers the fundamentals clearly.
What cable types do you actually encounter at events?
Knowing what you are working with determines how you protect it. The cables on a typical event site fall into a handful of categories, each with different handling requirements.
Power cables
- SOOW flexible cable: heavy-duty rubber-sheathed cable rated for outdoor use and mechanical stress; the standard choice for temporary power feeds.
- BS EN 60309 distribution leads (Ceeform): colour-coded by voltage and current rating (blue = 230 V single-phase, red = 400 V three-phase); the correct connector type for temporary event distribution.
- Single-core armoured cable (SWA): used for buried or semi-permanent runs; requires correct gland terminations and is not suitable for casual surface laying.
Signal and control cables
- Multicore audio snakes: bundle multiple balanced audio lines into a single sheath; reduce clutter but still require segregation from power runs to avoid hum.
- DMX512 control lines: the standardised protocol for lighting control; sensitive to interference from nearby power cables and should always be routed separately, ideally in a dedicated duct or at least 300 mm from power runs.
- EtherCon/Cat6 data cables: used for network, video and control; fragile connectors that need protection from foot traffic and should never share a cable ramp channel with power cables.
Handling basics that prevent failures

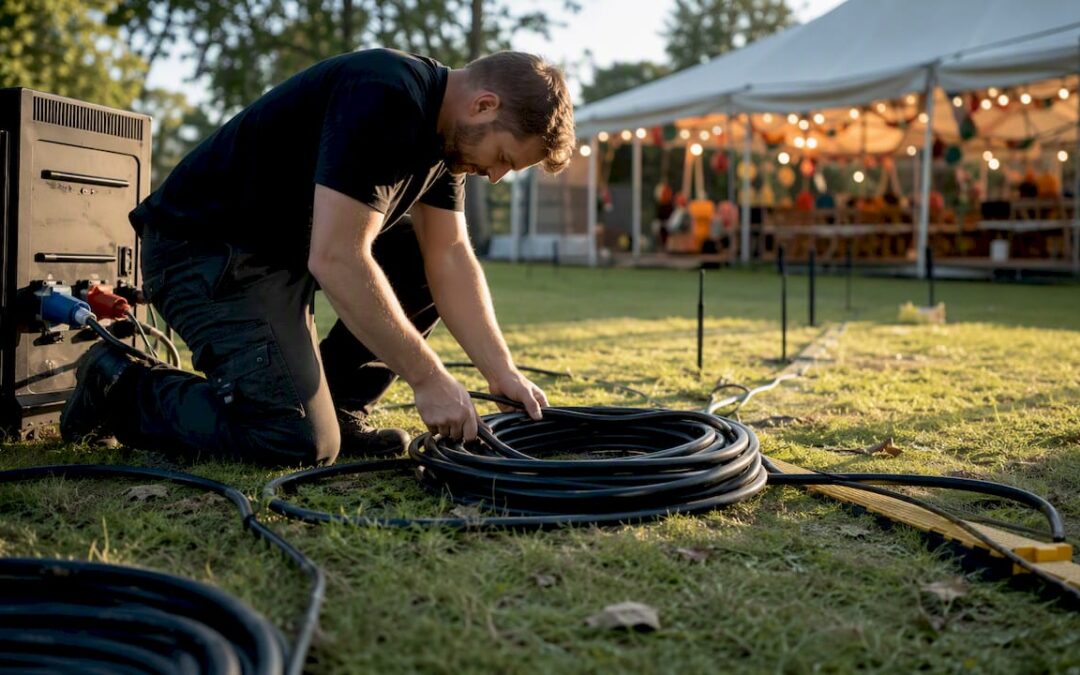

- Always uncoil drums completely before connecting under load. A partially wound reel can overheat and start a fire because the coiled section cannot dissipate heat effectively.
- Never kink or crush cables during installation; a damaged sheath on an outdoor power cable is a live hazard in wet conditions.
- Use only connectors rated for the cable’s current and voltage; undersized connectors are a common cause of overheating at events.
- Store coiled cables on proper reels between events; loose coiling causes internal conductor damage over time.
Single-core outdoor runs and any cable exposed to direct heat sources (generators, catering equipment, stage lighting rigs) should be treated as high-risk and inspected more frequently during the event.
How do you integrate cable routing into the site plan?
Cable routing decided on the day of build is cable routing that creates hazards. HSE event-safety guidance is clear: routing must be considered during the initial site layout, before structures, fencing and vehicle access points are fixed. Once a scaffold stage is up, your cable options narrow dramatically.
What to map before anything else
Start with the fixed points: the mains intake or generator location, the position of distribution boards, and the stage or performance area. Draw lines between them and then overlay the site’s vehicle access routes, pedestrian flows, emergency exits and any drainage channels. Where those lines cross, you have a problem to solve before build day.
The Purple Guide prescribes that production infrastructure and power distribution positions must be finalised during site design, not retrofitted. That means the production manager and the electrical contractor need to be in the same conversation at the planning stage, not introduced to each other on the morning of the build.
Labelling and colour-coding
A cable that nobody can identify is a cable that will be disconnected at the wrong moment. Adopt a simple, consistent labelling scheme before the first reel is uncoiled.
| Zone | Label colour | Example use |
|---|---|---|
| Stage power | Red | Generator feed, stage distribution board |
| Front-of-house | Yellow | Mixing desk, lighting control, comms |
| Public/audience area | Green | Catering, bar, public lighting |
| Service/backstage | Blue | Crew facilities, production office |
Apply cable ties with printed labels at every junction, every ramp entry and exit, and at each end of every run. A site electrician who arrives mid-event to fault-find will thank you for it.
Pro Tip: Mark cable corridors on the site plan with a hatched line and a minimum width (typically 600 mm clear either side of the cable). Share that plan with the site manager, the vehicle marshal and the stage crew so nobody places a flight case or a barrier post directly on a live run.
For a detailed look at how cabling decisions feed into overall event reliability, the Jakspartypower guide on cabling and event reliability is worth reading alongside this section.

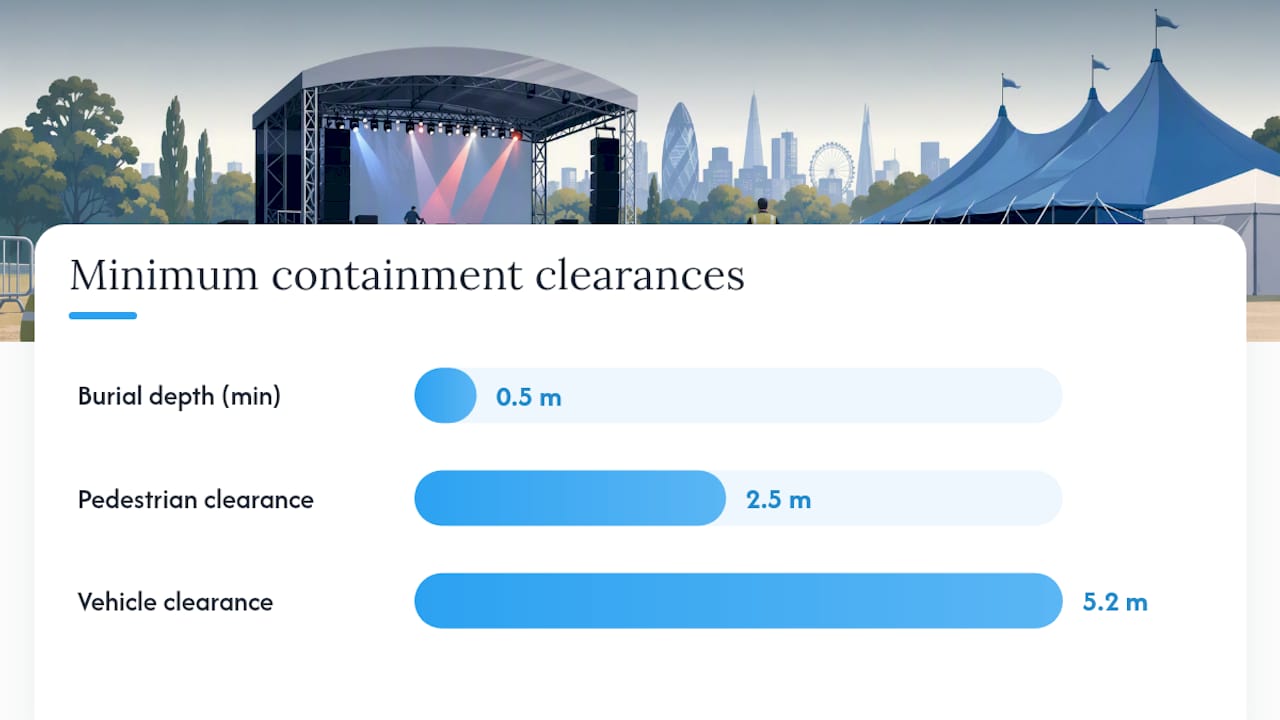

What containment options actually protect cables on site?
Containment is where good planning either holds or falls apart. The right product for each location depends on the traffic type, the cable diameter and whether the run is temporary or semi-permanent.
Common containment options
- Cable ramps: rubber or polyurethane ramps with a channel sized to the cable diameter; rated for pedestrian and, in heavier versions, vehicle traffic. The correct choice for any surface crossing.
- Cable bridges (overhead): aluminium or steel catenary systems that carry cables above head height; used where ground-level crossings are impractical or where vehicle clearance is needed.
- Multicore snakes and ducts: bundle multiple cables into a single protected sheath; reduce the number of individual runs crossing a space and simplify labelling.
- Conduit and trunking: rigid or flexible conduit used where cables run along structures, under flooring or through temporary walls.
- Trenching: for longer semi-permanent runs, cables can be buried in a trench; guidance recommends a minimum burial depth of approximately 0.5 m for temporary supplies where vehicles may cross.
- Overhead catenary runs: where ground crossings are not possible, cables can be suspended from a catenary wire; minimum clearance heights apply (typically 5.2 m for vehicle routes, 2.5 m for pedestrian-only areas).
Installation points that matter
- Anchor ramps at both ends so they cannot shift under traffic; an unsecured ramp becomes a trip hazard faster than an unprotected cable.
- Match the ramp’s load rating to the heaviest vehicle that will cross it. A pedestrian ramp under a forklift is not protection; it is a cable crusher.
- Use rated covers at all junctions; do not leave connectors exposed on the ground surface.
Pro Tip: Gaffer tape is not mechanical protection. It is designed for adhesion and quick fixes, not for resisting compression or abrasion under foot or vehicle traffic. Using tape to “protect” a cable crossing is one of the most common and most dangerous shortcuts on event sites. If a cable needs protection, use a ramp or a duct.

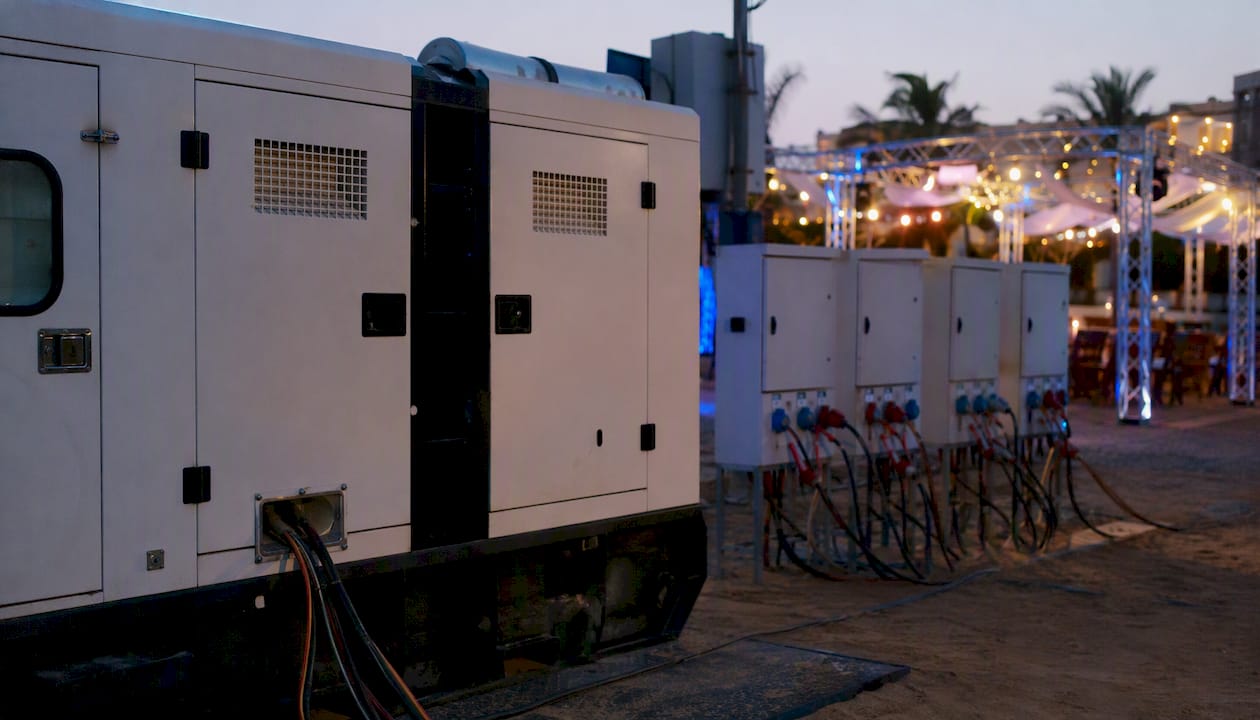

Generators, distribution boards, RCDs and UK compliance
Temporary power distribution at events is governed by BS 7909:2023 and BS 7671. Both standards apply simultaneously: BS 7909 covers the event-specific planning and competence requirements; BS 7671 governs the electrical installation itself.
Arranging the distribution
Generators should be sited away from public areas, with adequate ventilation, on level ground and with fuel storage that meets fire-safety separation distances. The output feeds into a main distribution board, which then supplies sub-distribution boards positioned closer to the load zones (stage, FOH, catering, public lighting). BS EN 60309 (Ceeform) sockets are the correct connection type for temporary event distribution; standard domestic sockets are not rated for the current demands or environmental conditions of an outdoor event.
HSE guidance recommends keeping lighting and audio on separate circuits, which also simplifies fault-finding: a tripped audio circuit does not take the stage lighting with it.
RCD and earthing requirements
| Device | Purpose | Test frequency |
|---|---|---|
| 30 mA RCD | Personal protection on all portable outlet circuits | Before first use; daily on multi-day events |
| 30 mA RCD | Discrimination at sub-distribution level | Before first use |
| Main isolator | Full system isolation in an emergency | Verify operation before energising |
| Earth electrode | Fault current path for generator systems | Verify resistance before energising |
GS50 advises RCD protection for all portable outlets. Every circuit supplying equipment that a member of the public or crew could touch must be protected by a 30 mA RCD. Generator systems that are not connected to the public supply network require their own earthing arrangement; the earth electrode resistance must be verified before the system is energised.
Earthing checklist before energising:
- Earth electrode installed and resistance measured (typically below 200 Ω for a TT system, though your electrician will confirm the target for your specific installation).
- All distribution board enclosures bonded to the earth conductor.
- Generator frame earthed and continuity verified to the distribution system.
- RCD test buttons pressed and operation confirmed on every device.
For guidance on distribution board installation and the role boards play at larger events, Jakspartypower has detailed resources covering both topics.
What pre-event checks should you complete before powering up?
A sequential test routine prevents the majority of faults that surface during an event. Work through this in order; do not skip steps because the schedule is tight.
- Visual inspection of all cables and connectors. Look for damaged sheaths, bent pins, cracked housings and any cable that has been run under a load or across a sharp edge. Replace, do not tape.
- Continuity and polarity checks. Verify that live, neutral and earth conductors are correctly connected throughout the distribution system. A reversed polarity fault on a 16 A outlet is invisible until something fails.
- Insulation resistance test. Measure insulation resistance on distribution cables before energising; a low reading indicates a damaged cable or a faulty piece of equipment connected to the circuit.
- RCD operation test. Press the test button on every RCD. Then use a calibrated RCD tester to verify trip time at rated sensitivity (30 mA RCDs must trip within 300 ms at rated current; most trip well under 40 ms).
- Earth continuity verification. Confirm the earth path from the generator frame through every distribution board to the final outlet.
- Load test. Where possible, energise circuits progressively and monitor for unexpected trips, voltage drop or overheating at connectors.
For a full inspection procedure including PAT guidance, the Jakspartypower event electrical equipment inspection guide covers each step in detail.
How often should you retest during a multi-day event?
| Event duration | Recommended retest interval |
|---|---|
| Single day | Visual check every 4 hours during operation |
| Multi-day (2–3 days) | Full visual + RCD test each morning before opening |
| Extended (4+ days) | Full visual + RCD test each morning; insulation resistance retest on day 3 |
The handover document must record: tests performed and results, RCD serial numbers and trip times, distribution board labelling, generator serial number, cable route map reference, any outstanding actions and the SPR’s signature. Without a signed handover document, there is no auditable record that the system was safe at the point of energisation.
How do you manage vehicle crossings, wet areas and high-traffic zones?
These three locations account for the majority of cable damage and electrical incidents at events. Each needs a specific approach rather than a generic “protect the cable” instruction.
- Vehicle crossings. The choice between a surface ramp, a buried duct and an overhead catenary depends on the crossing frequency and vehicle weight. For occasional light vehicles (golf buggies, small vans), a heavy-duty rated cable ramp is sufficient. For regular HGV crossings, bury the cable in a duct at a minimum depth of approximately 0.5 m, as technical guidance recommends, or route overhead at a minimum clearance of 5.2 m. Never rely on a pedestrian-rated ramp for vehicle traffic.
- Wet areas and water exposure. Any connector or junction box in an area exposed to rain, hosing or standing water must carry a minimum IP44 rating; IP65 or above is preferable for outdoor use. Route cables away from drainage channels and low points where water pools. Where a cable must pass through a wet area, use a sealed junction rather than an open connector. Identify the emergency isolation point for each wet-area circuit and mark it clearly so crew can isolate quickly if water ingress occurs.
- High-pedestrian-traffic zones. Audience areas require cable ramps at every crossing, with the ramp colour contrasting with the ground surface so it is visible. Secure ramps with ground anchors or heavy-duty tape at the edges only (not over the cable channel). Post a crew member at high-traffic crossings during peak crowd movement, if the ramp cannot be made fully flush with the surface.
- Emergency routes. No cable, ramp or duct may obstruct a designated emergency exit or evacuation route. Mark these routes on the site plan before cable corridors are drawn; the emergency route takes priority over every cable run.
- Catering and heat-generating equipment. Keep power cables at least 300 mm from catering equipment, generators and any heat source. Use heat-resistant cable where proximity cannot be avoided, and inspect those runs more frequently.
Who is responsible, and what does the handover document contain?
Accountability on an event site is not a bureaucratic exercise. When something goes wrong, the question of who signed off what determines both the legal outcome and how quickly the problem gets fixed.
Responsibility matrix
- Senior Person Responsible (SPR): oversees the entire electrical installation; signs the handover document; is the point of contact for the duty holder throughout the event. Must be competent in temporary electrical systems per BS 7909.
- Installing electrician: carries out the physical installation, testing and inspection; reports defects to the SPR before handover; must hold appropriate qualifications (typically a Part P or equivalent competence for temporary systems).
- Production manager: co-ordinates the electrical contractor’s access to the site; communicates load requirements and schedule changes; does not sign off electrical safety but must understand the system’s limits.
- Client representative / duty holder: receives the signed handover document; is responsible for ensuring the system is not modified without the SPR’s knowledge; retains the document for the duration of the event and for a reasonable period afterwards.
What the handover document must contain
- Name and contact details of the SPR.
- Date and time of handover.
- List of tests performed, with results (continuity, polarity, insulation resistance, RCD trip times).
- RCD serial numbers and their circuit assignments.
- Distribution board labelling and circuit schedule.
- Generator make, model and serial number.
- Cable route map reference (attach or cross-reference the site plan).
- Any outstanding actions or known defects, with agreed resolution timescales.
- Signatures of the SPR and the client representative.
Keep the original document on site throughout the event. A copy should be retained by both the contractor and the client after the event. If the installation is modified during the event (a circuit added, a cable rerouted), the SPR must re-inspect the affected section and update the document before re-energising.
What are the most common failures and red flags to watch for?
Most electrical incidents at events are predictable. The same mistakes appear repeatedly, and most of them are visible during the build if you know what to look for.
- Coiled cable drums under load. A reel that has not been fully unwound before use will overheat in the coiled section. The outer turns insulate the inner turns; heat builds and the insulation degrades. Uncoil completely, every time.
- Daisy-chained adapters and extension leads. A 13 A domestic extension lead daisy-chained from a 16 A Ceeform outlet is not a distribution solution; it is a fire risk. Each piece of equipment should be connected to a rated outlet on the distribution board. See the Jakspartypower guide on common event setup mistakes for a fuller list of these errors.
- Overloaded splitters. A two-way splitter does not increase the circuit’s capacity; it divides it. Calculate the total load before connecting multiple items to a single outlet.
- RCD nuisance tripping. Repeated tripping on a 30 mA RCD usually indicates a leakage current fault in connected equipment, not a faulty RCD. Isolate equipment one item at a time to identify the source; do not bypass or replace the RCD with a higher-rated device.
- Inadequate earthing on generator systems. A generator without a verified earth electrode is a system waiting to fail. Verify earth continuity before energising, not after the first fault.
- Cables run under temporary flooring without protection. Flooring panels concentrate load; a cable run under dance-floor panels without a duct or conduit will be crushed within hours.
- No labelling on distribution boards. An unlabelled board means every fault-finding exercise starts from scratch. Label every circuit before energising.
When to stop the build and call a competent electrician: if you find a damaged cable sheath on a live circuit, a distribution board with signs of overheating (discolouration, burning smell), an RCD that will not reset, or any situation where the earth path cannot be verified, stop work on that circuit and call the SPR or a qualified electrician. Do not improvise a fix under time pressure.
Practical checklist and a sample handover template
The following checklist and template are provided by Jakspartypower as a practical starting point for event organisers. They are not a substitute for a full electrical inspection by a competent person, and they do not constitute a legal certificate. Adapt them to the scale and complexity of your event; a small private party needs a shorter version than a three-day festival.
For a ready-made risk assessment resource, the Jakspartypower event power risk assessment checklist is a useful companion document.
Pre-event checklist (printable format)
- Site plan with cable corridors, vehicle crossings and emergency routes marked.
- SPR named in writing and on site.
- All cable drums fully uncoiled before connection.
- Cable types identified and segregated (power from signal/data).
- Containment in place at all crossings (ramps, bridges or buried ducts).
- All connectors rated for the circuit (BS EN 60309 where required).
- Distribution boards labelled with circuit schedules.
- RCDs tested and trip times recorded.
- Earth continuity verified on all generator systems.
- Insulation resistance test completed on distribution cables.
- Handover document completed and signed by SPR and client representative.
- Emergency isolation points identified and communicated to site crew.
- Spare cables, connectors and RCDs available on site.
Sample handover template fields
- Event name and date.
- SPR name, qualification and contact number.
- Installing electrician name and qualification.
- Generator details: make, model, serial number, fuel type.
- Distribution boards: number, location, circuit schedule attached (Y/N).
- Tests performed: continuity (pass/fail), polarity (pass/fail), insulation resistance (MΩ value), RCD trip times (ms per device).
- Outstanding actions: description, responsible person, agreed completion time.
- Cable route map: attached (Y/N) or reference number.
- Handover time and date.
- SPR signature.
- Client representative signature.
Jakspartypower’s 40+ years of electrical contracting experience informs every field in this template. The most frequently omitted item is the outstanding actions section; organisers tend to skip it when the build is running late. That is precisely when it matters most, because an unresolved action at handover becomes an unmanaged risk during the event.
For smaller events, the networking event electrical setup guide shows how to scale these principles down without losing the safety essentials.
What long-term event power work actually teaches you
Three things consistently separate events that run without electrical incident from those that do not, and none of them are about buying better equipment.
The first is that planning conversations happen too late. The electrical contractor is often the last person brought into the site design process, after the stage position, the fencing layout and the vehicle access points are already fixed. By that point, the cable routes are dictated by what is left, not by what is safe. The organiser who invites the electrician into the first site-design meeting gets a fundamentally different result from the one who calls them the week before the event.
The second lesson is that simplicity in distribution is a safety feature, not a cost-cutting measure. Every additional sub-distribution board, every extra cable run, every improvised extension is another point of failure. The best temporary power systems are the ones where every circuit can be traced from source to load in under two minutes. When a fault develops at 11 PM on a Saturday, that traceability is the difference between a five-minute fix and a cancelled show.
The third is redundancy, but not the kind most people think of. Spare cables and spare RCDs matter less than a spare competent person who knows the system. If the SPR leaves site for any reason, there must be someone else who has read the handover document and can make decisions about the installation. That is not a luxury on a multi-day event; it is a basic continuity requirement.
Pro Tip: When a last-minute change arrives (a new piece of equipment, a relocated stage, an added catering unit), do not absorb it informally. Run it past the SPR, check the circuit capacity, and update the handover document before connecting anything. A five-minute conversation prevents a three-hour fault-finding exercise.
Jakspartypower: event power and cable management support in Sussex
Forty years of electrical contracting experience is a long time to learn what goes wrong on event sites. Jakspartypower brings that knowledge directly to the hire and setup process, which means you are not just renting equipment; you are getting the judgement that comes with it.
For events in Sussex and the surrounding area, Jakspartypower supplies generators, distribution boards, rated cables and accessories, and on-site electrical support including inspection, testing and a signed handover document. The standby service means a qualified person remains available throughout the event, not just during the build. Whether you are running a private wedding, a corporate show or a large outdoor festival, the package is built around your load requirements and site layout, not a generic template.
To discuss your event’s power requirements and get a quote, contact Jakspartypower directly through Jakspartypower.
Sources
- BS 7909: temporary electrical systems for entertainment and related purposes — BSI Knowledge
- Electrical safety at places of entertainment: Guidance Note GS50 (HSE)
- Temporary electrical systems — BBC safety resources
- Temporary electrical installations — Professional Electrician
For certified help and SPR responsibilities, contact a qualified electrical contractor registered with a competent person scheme such as NICEIC or NAPIT.
FAQ
What is BS 7909 and does it apply to small events?
BS 7909:2023 is the UK code of practice for temporary electrical systems at entertainment events. It applies to all temporary installations regardless of size, including small private events.
What does a Senior Person Responsible actually do?
The SPR oversees the design, installation, testing and handover of the temporary electrical system, and signs the handover document confirming the installation is safe. The BBC safety resources confirm this role is required even for small temporary systems.
Why must cable drums be fully uncoiled before use?
A partially wound reel cannot dissipate heat from the coiled section; the insulation degrades under load and the cable can overheat, creating a fire risk. Uncoil every drum completely before connecting it to a live circuit.
What RCD rating is required for portable outlets at events?
HSE guidance GS50 advises 30 mA RCD protection for all portable outlets at entertainment events; these must be tested before first use and daily on multi-day events.
Can Jakspartypower supply cables, distribution boards and on-site support together?
Yes. Jakspartypower provides generator hire, distribution boards, rated cables and on-site electrical support including inspection, testing and a signed handover document for events in Sussex. Contact them via Jakspartypower for a quote.
